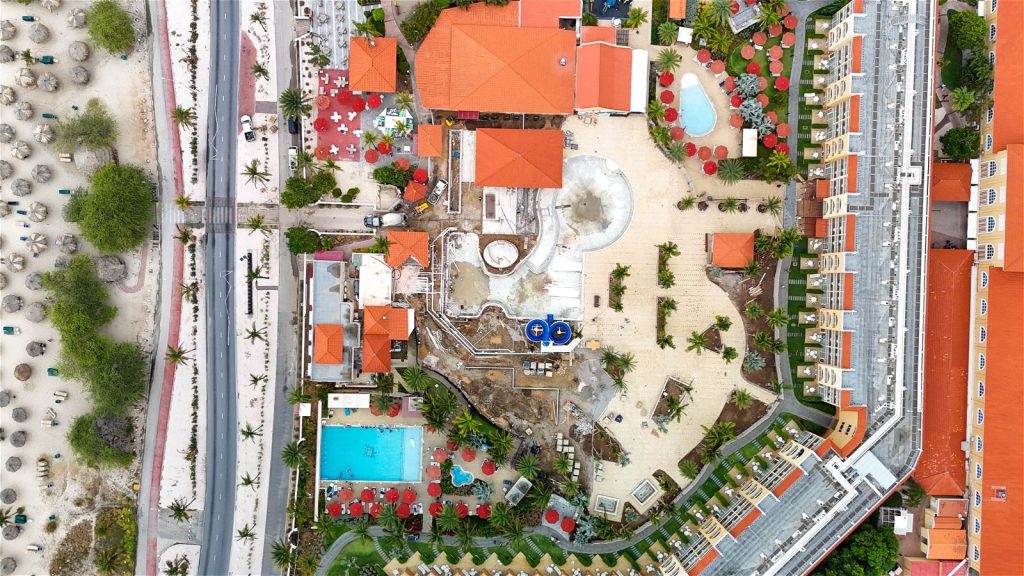

PHASE 2B UPDATES
Renovation Update #19
SEPTEMBER 23, 2025
- Concrete pouring is progressing in phases.
- Over 60% of the floor tiles have been installed across the bar surface.
- Pavers installation @ bar perimeter is ongoing.
- Interior floor tile installation is complete.
- Interior wall panel installation is complete.
- Countertop installation around the bar begins today (Friday).
- Bar equipment is scheduled for delivery on Monday morning.
- Light fixtures and electrical installations are upcoming.
- Concrete works are underway.
- Column installation will begin shortly.
- Planter installation behind the stage is scheduled to take place next week.
- Carpentry installation is scheduled for next week.
- Window and door installation will follow.
- Back Ramp pavers installation as well.
- Contractor will begin installing footings for the mesh structure on Monday.
- The pool contractor was scheduled to complete the piping installation by Saturday. However, due to current weather conditions, this is postponed for this week.
- Pipe pressure testing will be completed this week.
- Excavation is underway between the Bar and Restaurant for drainage piping and future paver installation (pattern approval pending).
- Paver replacement in the walkway area on the east side (breezeway tunnel) is done.
- Punch list inspections for the 3rd and 4th floor suites were completed last Wednesday. Contractors are addressing all noted items.
- Punch list for the 2nd floor suites is scheduled for Monday, and for the 1st floor suites on Wednesday.
- Furniture transport began today (Friday), continuing Saturday for the 3rd and 4th floor suites.
- The contractor started yesterday the installation of the wallpapers in the 4th floor suites.
- Carpenter is actively installing millwork on the 1st and 2nd floors.
- The electrical contractor is handling light fixture and outlet/switch installations.
- Plumbing tests are being done across all floors today (Friday).
Actualización #19
- El vaciado de concreto avanza por fases.
- Se ha instalado más del 60% de los azulejos en la superficie del bar.
- La instalación de adoquines en el perímetro del bar está en curso.
- La instalación de azulejos en el piso interior está completa.
- La instalación de paneles en las paredes interiores está completa.
- La instalación de la barra comienza hoy (viernes).
- El equipo del bar está programado para entregarse el lunes por la mañana.
- Próximamente se instalarán luminarias y componentes eléctricos.
- Se están realizando trabajos de concreto.
- La instalación de columnas comenzará en breve.
- La instalación de jardineras detrás del escenario está programada para la próxima semana.
- La instalación de carpintería está programada para la próxima semana.
- La instalación de ventanas y puertas será posterior.
- También se instalarán adoquines en la rampa trasera.
- El contratista comenzará la instalación de las bases para la estructura de malla el lunes.
- El contratista tenía programado completar la instalación de tuberías para el sábado. Sin embargo, debido a las condiciones climáticas actuales, esto se ha pospuesto para esta semana.
- Las pruebas de presión de las tuberías se completarán esta semana.
- Se está realizando excavación entre el bar y el restaurante para la instalación de tuberías de drenaje y futuros adoquines (pendiente aprobación del patrón).
- Se ha completado el reemplazo de adoquines en el área del camino peatonal del lado este (túnel de brisa).
- Las inspecciones de la lista de verificación para las suites del tercer y cuarto piso se completaron el miércoles pasado. Los contratistas están atendiendo todos los puntos señalados.
- La lista de verificación para las suites del segundo piso está programada para el lunes, y para las del primer piso el miércoles.
- El transporte de muebles comenzó hoy (viernes) y continuará el sábado para las suites del tercer y cuarto piso.
- El contratista comenzó ayer la instalación de papel tapiz en las suites del cuarto piso.
- El carpintero está instalando acabados de madera en los pisos primero y segundo.
- El contratista eléctrico está instalando luminarias y tomacorrientes/interruptores.
- Se están realizando pruebas de plomería en todos los pisos hoy (viernes).

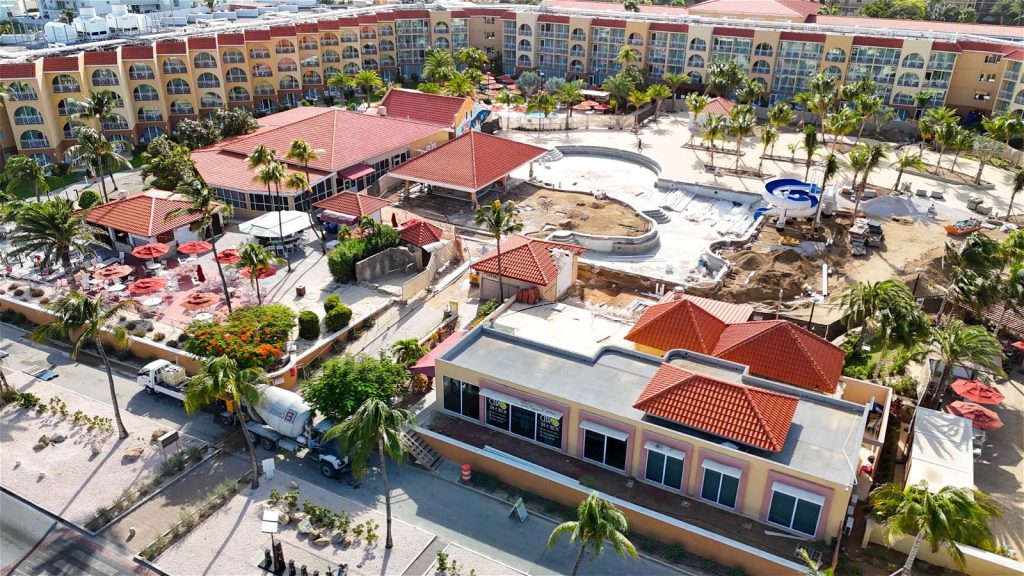

Renovation Update #18
- Bar: Concrete floor pouring completed
- Ceiling Painting: Ongoing
- Tiling: Floor and wall tiling has commenced
- Band Stand Foundation: Concrete pouring in progress
- Towel Hut Access Ramp: Foundation work and concrete pouring underway
- Pool Piping: Installation expected to be completed by Friday
- Pool Consultant’s visit scheduled for September 9–11
- South Side Planters: Foundation and wall construction ongoing
- West Side Planters: Masonry walls and surface plastering in progress
- All millwork by Aruwood was completed last week; final detailing is currently underway.
- Final coat of paint and wooden door painting in progress
- Painting work ongoing – ceiling and walls
- Millwork by Aruwood in progress
- Shower tiling completed
- Wall and ceiling surface preparation ongoing; first coat of paint scheduled for Monday (Sept08)
- Millwork installation to begin this coming Wednesday(Sept10)
- Shower floor tiling in progress
- Facade – Exterior Walls Repair work and surface preparation underway
- Ceiling structure and paneling installation in progress
- Wall and ceiling surface preparation ongoing
- Waterproofing material applied to shower floor in preparation for tiling
- Millwork installation scheduled to begin this coming Friday(Sept11)
Actualización #18
Novedades de la Fase 2B de nuestra renovación:
- Barra: Vertido de piso de concreto completado
- Pintura del techo: En curso
- Enchapado: Se ha iniciado el enchapado de pisos y paredes
- Fundación del escenario de la banda: Vertido de concreto en progreso
- Rampa de acceso a la cabaña de toallas: Trabajo de cimentación y vertido de concreto en curso
- Tuberías de la piscina: Se espera que la instalación esté completada para el viernes
- Visita del consultor de piscinas: Programada del 9 al 11 de septiembre
- Jardineras del lado sur: Cimentación y construcción de muros en curso
- Jardineras del lado oeste: Muros de mampostería y enlucido superficial en progreso
4.º Piso
- Todo el trabajo de carpintería realizado por Aruwood fue completado la semana pasada; actualmente se están realizando los detalles finales
- Capa final de pintura y pintura de puertas de madera en progreso
3.º Piso
- Trabajo de pintura en curso – techo y paredes
- Carpintería por Aruwood en progreso
- Enchapado de duchas completado
2.º Piso
- Preparación de superficies de paredes y techo en curso; primera capa de pintura programada para el lunes (8 de septiembre)
- Instalación de carpintería comenzará este miércoles (10 de septiembre)
- Enchapado del piso de la ducha en progreso
- Fachada – Reparación de muros exteriores y preparación de superficies en curso
1.º Piso
- Instalación de estructura de techo y paneles en progreso
- Preparación de superficies de paredes y techo en curso
- Material impermeabilizante aplicado al piso de la ducha en preparación para el enchapado
- Instalación de carpintería programada para comenzar este viernes (11 de septiembre)

Renovation Update #17
- Pata Pata Bar: Concrete floor preparation is underway, including drain placement and level definition.
- Pata Pata Bar: Phase 1 concrete pouring is scheduled for Friday morning.
- Pata Pata Bar: Phase 2 concrete pouring will follow on Monday.
- Trellis column footings have been located and excavation is in progress.
- Contractor is currently installing cabling at the bar and in the new technical room.
- Contractor is installing the latest floor drain at the pool deck access (south side).
- On Monday, Contractor began trench excavation in front of the future Gelateria; this activity is expected to take two days.
- Pool contractor will begin installing the piping extension on Wednesday, August 27. This task is expected to last two weeks.
- The fence at Eduardo’s area has been relocated to allow construction of the new raised planter and completion of the concrete flooring around the bar.
- The contractor is installing new ceiling structures in the guest bedrooms on the 2nd and 3rd floors.
- On Thursday, wall and ceiling surface preparation will begin for painting finishes, allowing millwork contractor to start kitchen installations on the 4th floor next Monday, September 2.
- Balcony flooring work is ongoing on the 3rd and 4th floors.
- Shower floor installations are in progress on the 4th floor.
Actualización #17
Novedades de la Fase 2B de nuestra renovación:
- Barra Pata Pata: Se está preparando el piso de concreto, incluyendo la colocación de drenajes y la definición de niveles.
- Barra Pata Pata: El vaciado de concreto de la Fase 1 está programado para la mañana del viernes.
- Barra Pata Pata: El vaciado de concreto de la Fase 2 se realizará el lunes.
- Se han ubicado las zapatas de las columnas del enrejado y se está realizando la excavación.
- El contratista está instalando el cableado en la barra y en el nuevo cuarto técnico.
- El contratista está instalando el último drenaje de piso en el acceso a la terraza de la piscina (lado sur).
- El lunes, el contratista comenzó la excavación de zanjas frente a la futura Gelateria; se espera que esta actividad dure dos días.
- El contratista de la piscina comenzará la instalación de la extensión de tuberías el miércoles 27 de agosto. Se espera que esta tarea dure dos semanas.
- La cerca en el área de Eduardo ha sido reubicada para permitir la construcción del nuevo macetero elevado y la finalización del piso de concreto alrededor de la barra.
- El contratista está instalando nuevas estructuras de techo en las habitaciones de huéspedes del segundo y tercer piso.
- El jueves comenzará la preparación de superficies de paredes y techos para acabados de pintura, lo que permitirá al contratista de carpintería iniciar la instalación de cocinas en el cuarto piso el próximo lunes 2 de septiembre.
- Se continúa trabajando en el piso de los balcones en los pisos 3 y 4.
- Se están instalando los pisos de las duchas en el cuarto piso.

Renovation Update #16
- Waterslide materials arrived on Thursday, now part of the material is on the job site.
- Today the team is preparing everything to start with the installation until the 19th of August.
- The compaction process in slide area will begin once slide is installed.
- Trenches around the Pata Pata bar will be filled up and leveled, preparing the surface for the concrete slab.
- Tech. room will be ready this week. AV & sound system contractors will start their installations end of this week.
- . Layout of the umbrellas (in ground mounts) will begin soon at the adult pool.
- Approval for the private cabanas sofa was received and contractor will start manufacturing them and start on the building/renovation of cabanas.
- August 18 – kids playground cover structure can begin
- August 18 – concrete slab preparation around the bar
- Demolition: 4th and 3rd floor kitchens completed.
- 90% of the old goods are out from the suites.
- Millwork contractor will start to mark all the kitchens to prepare all the installations and avoid conflicts during the cabinet installations.
- Electricians will start with the relocations of the outlets in walls.
- Guest bedroom ceilings demolition will take place during the week.
Actualización #16
Nos complace compartir la última actualización sobre la renovación en curso de nuestra piscina principal y el área de la terraza, parte de la Fase 2B de nuestro plan general de mejoras.La finalización está prevista para diciembre de 2025.
Novedades de la Fase 2B de nuestra renovación:
- Los materiales del tobogán acuático llegaron el jueves; parte del material ya está en el sitio de trabajo.
- Hoy el equipo está preparando todo para comenzar la instalación, que se extenderá hasta el 19 de agosto.
- El proceso de compactación en el área del tobogán comenzará una vez que este esté instalado.
- Las zanjas alrededor del bar Pata Pata se rellenarán y nivelarán, preparando la superficie para la losa de concreto.
- El cuarto técnico estará listo esta semana. Los contratistas de sistemas AV y sonido comenzarán sus instalaciones a finales de esta semana.
- Pronto comenzará la instalación de las sombrillas (bases empotradas) en la piscina para adultos.
- Se recibió la aprobación para los sofás de las cabañas privadas; el contratista comenzará su fabricación y la construcción/renovación de las cabañas.
- 18 de agosto – Comienza la instalación de la estructura de cubierta del área de juegos infantiles.
- 18 de agosto – Preparación de la losa de concreto alrededor del bar.
- Demolición: cocinas del 4.º y 3.º piso completadas.
- El 90% de los artículos antiguos han sido retirados de las suites.
- El contratista de carpintería comenzará a marcar todas las cocinas para preparar las instalaciones y evitar conflictos durante la instalación de gabinetes.
- Los electricistas comenzarán con la reubicación de los tomacorrientes en las paredes.
- La demolición de los techos de los dormitorios de huéspedes se llevará a cabo durante la semana.

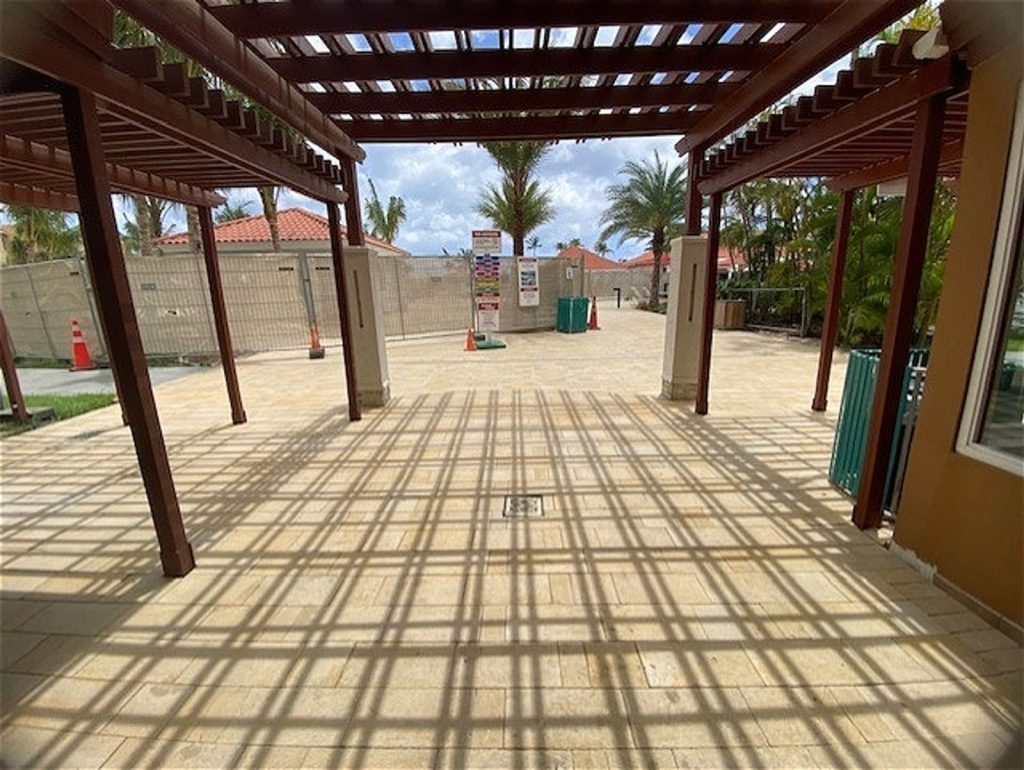

Renovation Update #15
Actualización #15
- Actualmente se están llevando a cabo trabajos en el Cuarto Técnico (parte trasera del centro de actividades).
- Bar Pata Pata: la pintura y la instalación de azulejos están programadas para comenzar esta semana.
- La instalación del tobogán acuático se ha retrasado debido a un problema con la entrega de materiales; ahora se planea iniciar entre el 10 y el 19 de agosto.
- El arquitecto proporcionará un diseño revisado con medidas actualizadas para la instalación de sombrillas y áreas de descanso tanto en la terraza de la piscina como en la piscina para adultos.
- Todos los contenedores de mobiliario, accesorios y equipamiento (FF&E) fueron entregados el jueves pasado. El último contenedor se entregó hoy (lunes).
- El sábado pasado se instalaron los FF&E en las suites del cuarto piso.
- El domingo pasado se realizó la limpieza de las habitaciones del tercer piso.
- Hoy (lunes): entrega de FF&E a las suites del tercer piso.
- Martes: limpieza de las habitaciones del segundo y primer piso.
- Miércoles: entrega de FF&E a las habitaciones del segundo y primer piso.
- La instalación de cortinas está programada para comenzar hoy, y el envío de telas se recibirá mañana (martes).
- La diseñadora de interiores llega hoy y comenzará a revisar y coordinar los artículos decorativos a partir de mañana.

Renovation Update #14
July 15, 2025 – Pool and Pool Deck Renovation
- Paving of the east area continues in zones unaffected by trenching.
- At Pata Pata Bar, electrical and low-voltage piping is being installed in the ceiling.
- Waterslide materials and the technician are expected @ July 28th. Installation is projected to take 7–10 days.
- Once installation is complete and trenching definitions are approved, piping work will proceed through the mechanical room.
- Activities at the Trellis and Bandstand remain on hold pending approval of the backfilling, concrete slab construction details, and footing details for columns near the pool edge.
- We’re also waiting on repairs to the paver surface at the Breezeway entrance so we can plan for reopening that area to La Cabana.
- Kitchen and bathroom vanity installations began as scheduled.
- We encountered unexpected plumbing issues inside the vanities—specifically, the placement of drainage pipes and valves conflicted with the cabinet paneling and supports. These items have since been resolved.
- Carpenters are actively working on the 3rd and 4th floors.
- Painters are currently on the 1st and 2nd floors.
- We’re awaiting the arrival of the FF&E items in order to begin removing the remaining (stored) older goods from the rooms.
- Facade repairs are in progress.

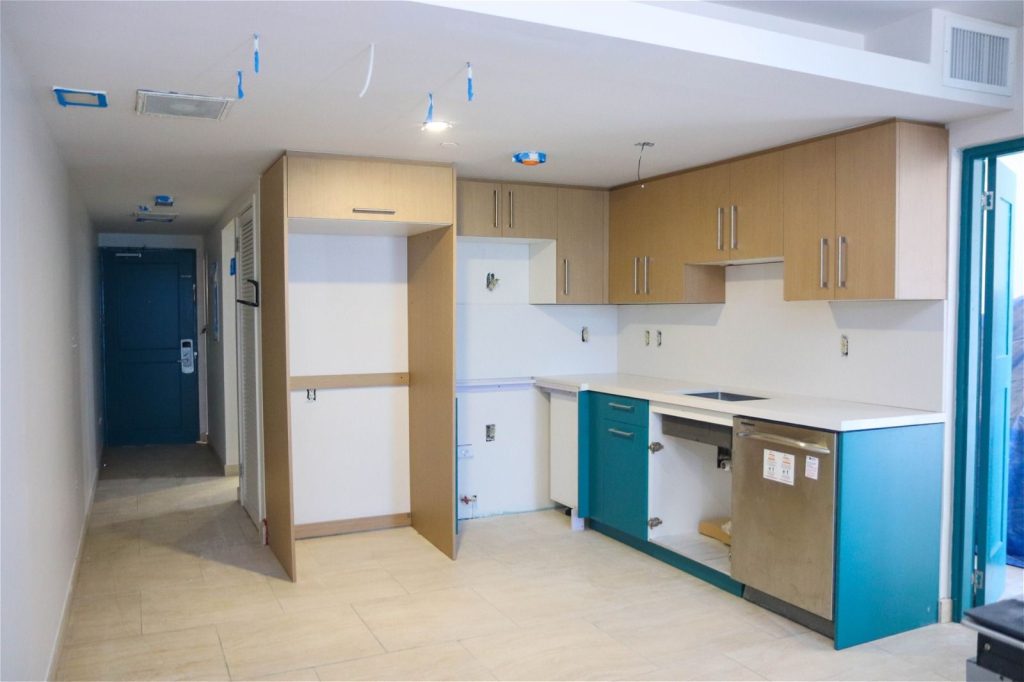

Actualización #14
July 15, 2025 – Renovación de la Piscina Principal y el Área del Deck
- Continúa el pavimentado del área este en las zonas no afectadas por las zanjas.
- En el bar Pata Pata, se están instalando tuberías eléctricas y de bajo voltaje en el techo.

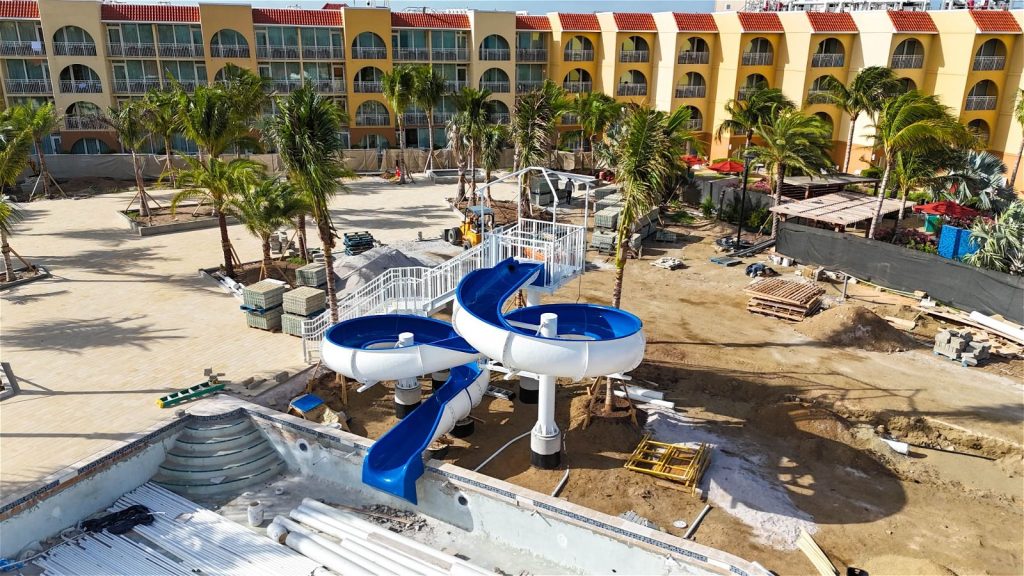

- Se espera la llegada de los materiales para el tobogán acuático y del técnico el 28 de julio. Se proyecta que la instalación tomará entre 7 y 10 días.
- Una vez completada la instalación y aprobadas las definiciones de las zanjas, se procederá con los trabajos de tubería a través del cuarto mecánico.
- Las actividades en la Pérgola y el Templete permanecen en espera hasta que se aprueben los detalles del relleno, la construcción de la losa de concreto y los detalles de las zapatas para las columnas cerca del borde de la piscina.
- También estamos a la espera de las reparaciones de la superficie de adoquines en la entrada del Pasillo Cubierto (Breezeway) para poder planificar la reapertura de esa área hacia La Cabaña.
- Las instalaciones de cocinas y lavamanos de baño comenzaron según lo programado.
- Encontramos problemas de plomería no previstos dentro de los lavamanos—específicamente, la ubicación de las tuberías de desagüe y las válvulas interfería con los paneles y soportes del gabinete. Estos inconvenientes ya fueron resueltos.
- Los carpinteros están trabajando activamente en los pisos 3 y 4.
- Los pintores se encuentran actualmente en los pisos 1 y 2.
- Estamos a la espera de la llegada del mobiliario, equipos y accesorios (FF&E) para comenzar a retirar los bienes antiguos aún almacenados en las habitaciones.
- Las reparaciones de la fachada están en curso.

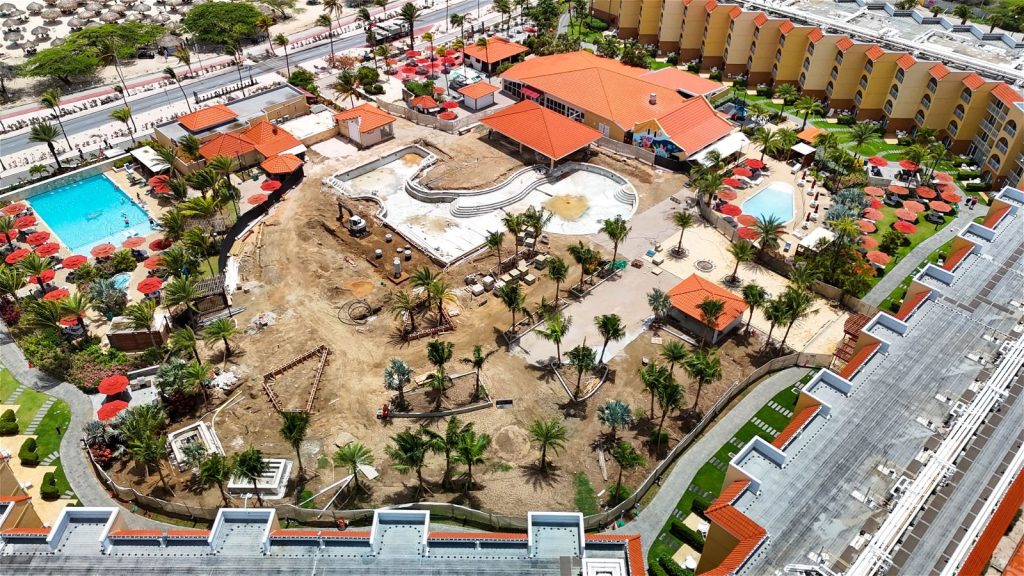

Renovation Update #13
- Waterslide Area: Backfilling of the foundation is underway. Surface preparation is in progress for the installation of piping, electrical, irrigation, and plumbing systems. The waterslide is scheduled to arrive during the third week of July.
- Towel Hut: Painting work continues.
- Breezeway Connection: Paving work is being finalized.
- Kids Pool Umbrellas: Bases have been successfully installed as planned.
- Main Pool: Waterline and coping installation are nearing completion.
- Tech Room (Kids Club): A proposal will be submitted to begin work in this area, with activities targeted to start on Monday, July 7.
- Pata Pata Bar: Installation is progressing well. Plastering is complete, and the flooring is ready for tile installation.
- Sbarro Kiosk: Demolition is scheduled for Monday, July 7. Walk-in service will be closed for two days during this phase.
- Construction Fencing: La Cabana will fence off the area on Sunday in preparation for construction fencing installation on Monday morning.
- Saturday Arrivals (June 1 – August 2, 2025):
- Units 145E, 146E, 245E, 246E, 345E, 346E, 445D, and 446D
- Sunday Arrivals (August 3 – October 5, 2025):
- Units 101E, 102E, 201E, 202E, 301E, 302E, 401D, and 402D
Logistics & Temporary Furnishings
Ocean Suites Current Progress:
4th Floor:
3rd & 2nd Floors:
1st Floor:

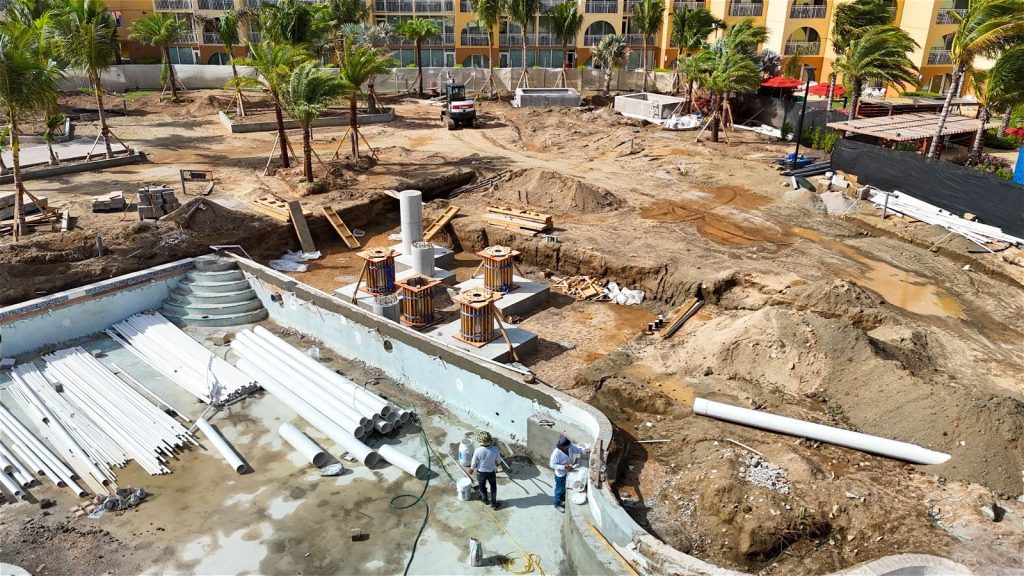

Renovation Update #12
- Towel Hut: Primer and painting work are underway on the walls and roof-exposed deck.
- Bar: Pouring of the interior concrete floor is in progress.
- Trellis: Column footings are being set, pending a structural decision on the columns closest to the pool.
- East Area: Paver installation has started; however, there is a minor issue with the pattern that is being addressed.
- Soil Compaction Test: Conducted today—awaiting results.
- Main Pool: Waterline tile and coping installation are ongoing.
- Kids’ Pool: Installation of shade umbrellas has begun on the west side.
- Pata Pata Bar: Renovation completion is now projected for September 2025.
- Saturday Arrivals (June 1 – August 2, 2025): Units 145E, 146E, 245E, 246E, 345E, 346E, 445D, and 446D
- Sunday Arrivals (August 3 – October 5, 2025): Units 101E, 102E, 201E, 202E, 301E, 302E, 401D, and 402D
- Demolition work is underway.
- New electrical systems are being installed in ceilings and walls.
- Sprinkler heads are being adjusted.
- Installation of new ceiling structures in the guest bedrooms has begun.
- Balcony floor tile installation is progressing from the 4th floor down to the 3rd floor.
La Cabana’s Team

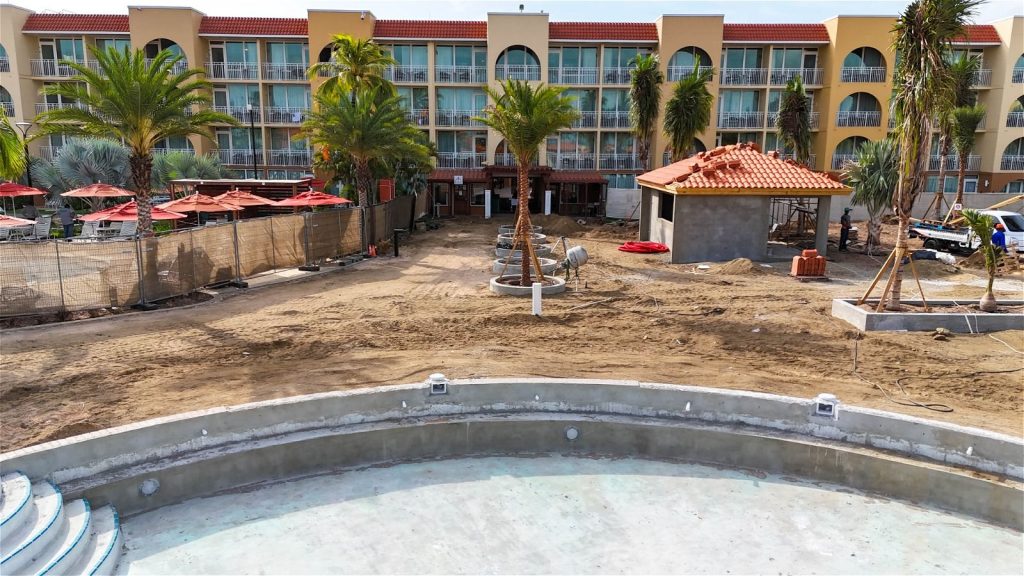

Renovation Update #11
- Roof tile installation is underway at the new towel hut.
- The area east of the main pool is being leveled and prepared for paving.
- Plumbing lines are being connected and pressure-tested to the pump room.
- All pool deck planters have been successfully built.
Ocean Front Suites Renovation – Update as of June 2025
As previously communicated, the renovation of our Ocean Front Suites officially began on June 1, 2025. This project marks an exciting step forward in enhancing the comfort and appeal of our most sought-after accommodations.
- Saturday arrivals (June 1 – August 2, 2025): Units 145E, 146E, 245E, 246E, 345E, 346E, 445D, and 446D
- Sunday arrivals (August 3 – October 5, 2025): Units 101E, 102E, 201E, 202E, 301E, 302E, 401D, and 402D
- A full interior renovation will be carried out in each suite, excluding the flooring and selected elements within the bathrooms.
- For suites on the third and fourth floors, the balcony tiles will be removed, and the slope regraded to improve drainage, preventing rainwater from entering the rooms.
- Renovation work on the Ocean Front suites (north side) is well underway, with scaffolding now in place to facilitate exterior improvements.
- FF&E (Furniture, Fixtures, and Equipment) is currently being removed from the suites, and interiors are being prepared for the next stage of contractor work.
Actualización #11
- Se está instalando el techo de tejas en la nueva caseta de toallas.
- El área al este de la piscina principal está siendo nivelada y preparada para el pavimento.
- Las líneas de plomería están siendo conectadas y sometidas a pruebas de presión hacia la sala de bombas.
- Todos los jardineros del área de la piscina han sido construidos con éxito.
- Llegadas los sábados (1 de junio – 2 de agosto de 2025): Unidades 145E, 146E, 245E, 246E, 345E, 346E, 445D y 446D
- Llegadas los domingos (3 de agosto – 5 de octubre de 2025): Unidades 101E, 102E, 201E, 202E, 301E, 302E, 401D y 402D
- Se llevará a cabo una renovación interior completa en cada suite, excluyendo el piso y algunos elementos seleccionados dentro de los baños.
- En las suites del tercer y cuarto piso, se retirarán las baldosas del balcón y se ajustará la pendiente para mejorar el drenaje y evitar que el agua de lluvia entre en las habitaciones.
- El trabajo de renovación en las suites frente al mar (lado norte) avanza bien, con andamios ya instalados para facilitar las mejoras exteriores.
- Actualmente se están retirando los muebles, accesorios y equipos (FF&E) de las suites, y los interiores se están preparando para la siguiente etapa del trabajo del contratista.

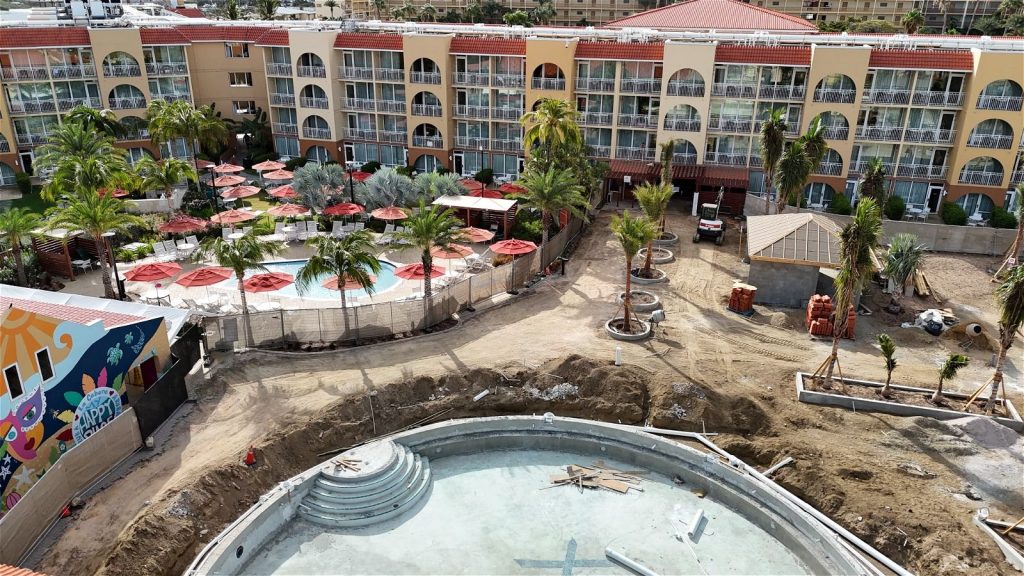

Renovation Update #10
Construction Progress Highlights:
- Access through the main tunnel to the pool deck has been closed to expedite the installation of new pavers and to update and install new drainage pipes at the west entry of the tunnel. The temporary towel hut and Gelateria remain accessible.
- Access holes to the pool pump room have been completed.
- Piping installation at the pool and Jacuzzis is being finalized.
- Jacuzzi forms have been poured.
- Preparation of the foundation for the new slide is underway.
- Installation of the new towel hut roof tiles is scheduled for next week.
- Geotextile fabric and paver installation will begin next week, starting on the east side of the pool.
- Demolition of the Pata Pata Bar floor is in progress to allow for linear floor drain installation, along with excavation for electrical and low-voltage conduits.
- A reminder that the north side Oceanfront Suites’ renovation begins on Saturday, May 31.
Actualización #10
Aspectos destacados del progreso de la construcción:
- El acceso a través del túnel principal hacia el área de la piscina ha sido cerrado para acelerar la instalación de nuevos adoquines y actualizar e instalar nuevas tuberías de drenaje en la entrada oeste del túnel. La cabaña temporal de toallas y la Gelateria siguen siendo accesibles.
- Se han completado los accesos a la sala de bombas de la piscina.
- Se está finalizando la instalación de tuberías en la piscina y los jacuzzis.
- Se han vaciado los moldes para los jacuzzis.
- Está en marcha la preparación de la base para el nuevo tobogán.
- La instalación de las nuevas tejas del techo de la cabaña de toallas está programada para la próxima semana.
- La instalación de la tela geotextil y los adoquines comenzará la próxima semana, empezando por el lado este de la piscina.
- Está en progreso la demolición del piso del Bar Pata Pata para permitir la instalación de un drenaje lineal, junto con la excavación para conductos eléctricos y de bajo voltaje.
- Recordatorio: la renovación de las suites frente al mar en el lado norte comenzará el sábado 31 de mayo.

Renovation Update #9
- Access to the adults-only pool will be available via the south side lobby landing.
- Access to the kids’ pool will be available via the north side lobby landing.
- We sincerely apologize for any inconvenience this may cause and appreciate your continued support and understanding as we move ahead with these improvements aimed at enhancing your experience at our resort.
Actualización #9

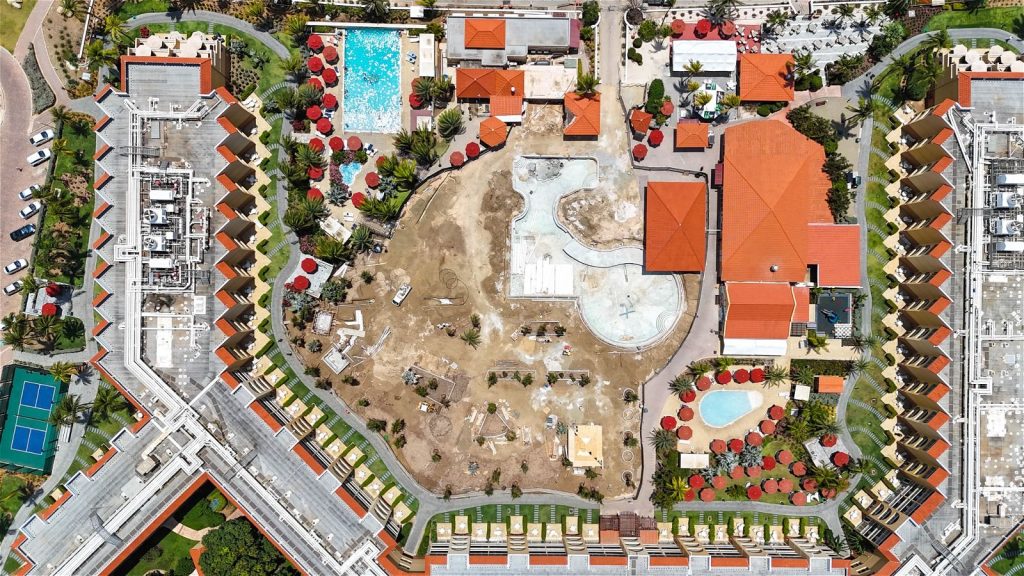

Renovation Update #8
May 6, 2025 – Pool and Pool Deck Renovation
- Installation of the new filtration system is advancing steadily. Pipes have already been laid around the East side of the pool and will soon be routed underneath the future Gelateria building.
- All outdated piping for the main pool into the pump house is being removed, with those sections to be sealed and restored.
- The new towel hut structure has been completed, and its elegant, tiled roof is expected to be finalized by mid-May.
- 80% of the planters around the pool deck have been built.
- Saturday section (June 1 – August 2, 2025): Units 145E, 146E, 245E, 246E, 345E, 346E, 445D, and 446D.
- Sunday section (August 3 – October 5, 2025): Units 101E, 102E, 201E, 202E, 301E, 302E, 401D, and 402D.
- The entire interior of each suite will be updated, with the exception of the flooring and selected areas of the bathroom.
- For the third- and fourth-floor units, the balcony tiles will be removed and the slope regraded to ensure proper drainage into the gutter system, preventing water from entering the rooms during rainfall.
ACTUALIZACIÓN #8 SOBRE LA RENOVACIÓN DE LA FASE 2B
6 de mayo de 2025 – Renovación de la Piscina y el Área de la Piscina
Renovación de la Piscina Principal y su Área – Informe de Progreso
Como muchos de ustedes saben, la renovación de nuestra piscina principal y el área que la rodea está en marcha, y se espera que el proyecto esté finalizado para diciembre de 2025. Esta emocionante transformación le dará nueva vida a uno de los espacios más queridos del resort y promete elevar significativamente su experiencia vacacional futura.
Mientras continúan los trabajos, nos complace informarles que tanto la piscina para adultos como la nueva piscina para niños permanecen completamente abiertas y accesibles para su disfrute.
Aspectos Destacados del Progreso de Construcción:
• La instalación del nuevo sistema de filtración avanza a buen ritmo. Ya se han colocado tuberías alrededor del lado Este de la piscina y pronto se dirigirán por debajo del futuro edificio de la Gelatería.
• Se están retirando todas las tuberías obsoletas que van desde la piscina principal hacia la sala de bombas; esas secciones serán selladas y restauradas.
• La nueva estructura del kiosco de toallas ya está construida, y se espera que su elegante techo de tejas esté terminado a mediados de mayo.
• El 80 % de los jardineras alrededor del área de la piscina ya han sido construidas.
Tenga en cuenta que las actividades de construcción pueden incluir perforaciones intermitentes, ruido de maquinaria y polvo en las áreas circundantes. Sabemos que estas molestias pueden ocasionar cierta incomodidad y pedimos disculpas por adelantado.
Agradecemos su paciencia y comprensión mientras seguimos mejorando las instalaciones del resort. Estas mejoras reflejan nuestro firme compromiso de brindar una experiencia excepcional a todos nuestros propietarios y huéspedes.
Renovación de las Suites Frente al Mar 2025 – Cronograma y Detalles
El 1 de junio de 2025 comenzaremos una renovación emocionante y completa de nuestras suites frente al mar —la joya de nuestras habitaciones. Estas mejoras están diseñadas para aumentar tanto la comodidad como el atractivo estético, conservando el encanto que ustedes tanto valoran.
Cronograma de Renovación:
• Sección de los sábados (1 de junio – 2 de agosto de 2025): Unidades 145E, 146E, 245E, 246E, 345E, 346E, 445D y 446D.
• Sección de los domingos (3 de agosto – 5 de octubre de 2025): Unidades 101E, 102E, 201E, 202E, 301E, 302E, 401D y 402D.
Alcance de la Renovación:
• Se actualizará todo el interior de cada suite, con excepción del piso y algunas áreas seleccionadas del baño.
• En las unidades del tercer y cuarto piso, se retirarán los azulejos de los balcones y se volverá a nivelar la pendiente para asegurar el drenaje adecuado hacia el sistema de canaletas, evitando así que el agua entre a las habitaciones durante las lluvias.
Logística y Actualización de Mobiliario:
Debido a los desafíos actuales con los aranceles y el transporte marítimo a nivel global, estamos gestionando la logística cuidadosamente para mantenernos dentro del presupuesto. La renovación requiere siete contenedores de muebles y materiales, que se están enviando directamente desde China y otros países hacia Aruba.
Lamentablemente, no se espera que los contenedores para las unidades del lado sur lleguen antes de mediados de agosto, lo que significa que las primeras ocho unidades renovadas conservarán temporalmente la mayor parte de su mobiliario actual hasta que lleguen los nuevos muebles. Agradecemos su comprensión y paciencia durante este breve período de transición.
Gracias por ser una parte valiosa de la familia La Cabana.

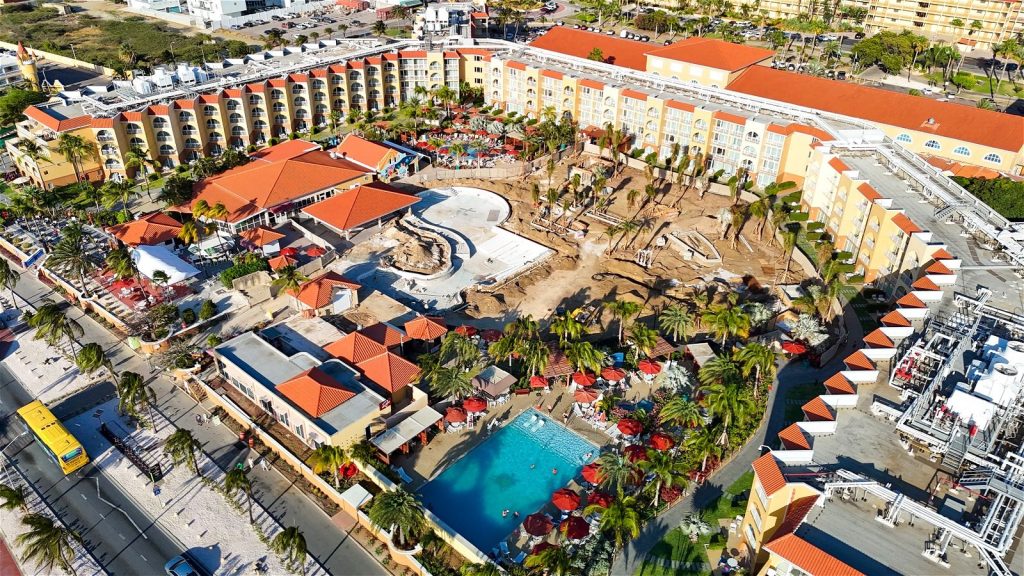

Renovation Update #7
- We are pleased to share that the foundation for the second Jacuzzi has been successfully poured, and the pipes have been laid out.
- Construction of the new towel hut is well underway—its walls are up, and the structure is taking shape.
- Meanwhile, the pool deck planters are being built, adding beautiful greenery and enhancing the aesthetic appeal of our pool area.
- We are also excited to announce that the renovation of the Pata Pata Bar is in progress.
- The pool sun shelf is currently being developed, offering a perfect spot for sunbathing and relaxation.
- Additionally, we have installed a sample in-ground mount umbrella at the kids pool.
Actualización #7
22 de abril de 2025 – 𝐀𝐜𝐭𝐮𝐚𝐥𝐢𝐳𝐚𝐜𝐢𝐨́𝐧 𝐝𝐞 𝐥𝐚 𝐓𝐞𝐫𝐫𝐚𝐳𝐚 𝐲 𝐥𝐚 𝐏𝐢𝐬𝐜𝐢𝐧𝐚
Queridos Propietarios/Huéspedes,
Como saben, la renovación de nuestra piscina y la terraza de la piscina está en pleno apogeo. Este es un proyecto importante, y seguimos totalmente comprometidos a mantenerlos informados con actualizaciones constantes a medida que avanzamos. La actualización de esta semana incluye varios desarrollos emocionantes:
Nos complace compartir que la base para el segundo jacuzzi ha sido vertida con éxito y las tuberías han sido instaladas.
La construcción de la nueva cabaña de toallas está en marcha: sus paredes están levantadas y la estructura está tomando forma.
Mientras tanto, se están construyendo los jardineras de la terraza de la piscina, añadiendo hermosas áreas verdes y mejorando el atractivo estético de nuestra zona de piscina.
También estamos emocionados de anunciar que la renovación del Bar Pata Pata está en progreso.
La repisa de sol de la piscina está siendo desarrollada, ofreciendo un lugar perfecto para tomar el sol y relajarse.
Además, hemos instalado una muestra de sombrilla montada en el suelo en la piscina para niños.
Agradecemos su paciencia y continuo apoyo mientras trabajamos arduamente para mejorar su experiencia en nuestro resort. ¡Estén atentos para más actualizaciones!

Renovation Update #6

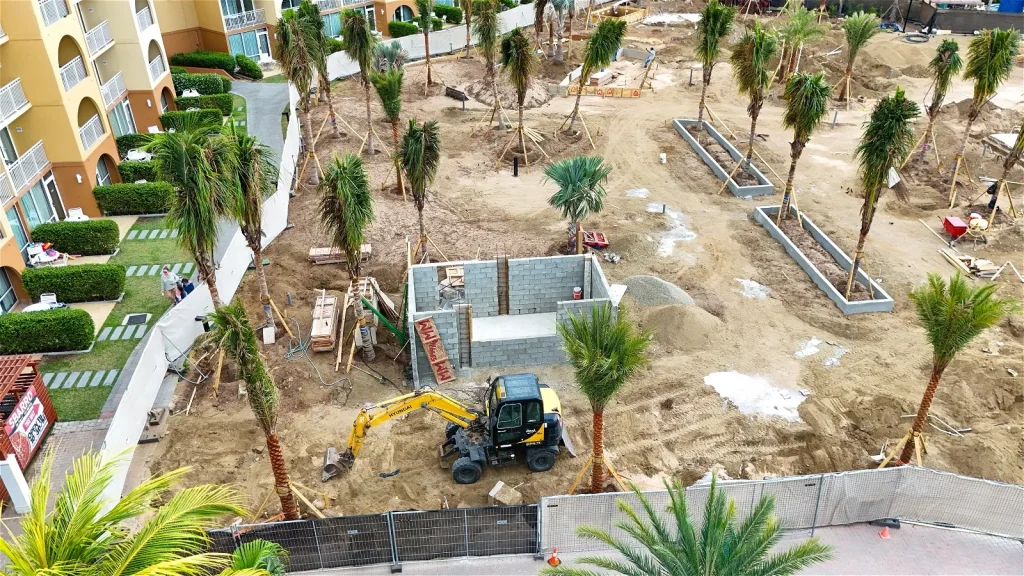

April 8, 2025 – 𝐏𝐨𝐨𝐥 𝐃𝐞𝐜𝐤 𝐚𝐧𝐝 𝐏𝐨𝐨𝐥 𝐑𝐞𝐧𝐨𝐯𝐚𝐭𝐢𝐨𝐧 𝐔𝐩𝐝𝐚𝐭𝐞
Actualización #6
April 8, 2025 – 𝐀𝐜𝐭𝐮𝐚𝐥𝐢𝐳𝐚𝐜𝐢ó𝐧 𝐬𝐨𝐛𝐫𝐞 𝐥𝐚 𝐑𝐞𝐧𝐨𝐯𝐚𝐜𝐢ó𝐧 𝐝𝐞 𝐥𝐚 𝐏𝐢𝐬𝐜𝐢𝐧𝐚 𝐲 𝐞𝐥 Á𝐫𝐞𝐚 𝐝𝐞 𝐥𝐚 𝐏𝐢𝐬𝐜𝐢𝐧𝐚

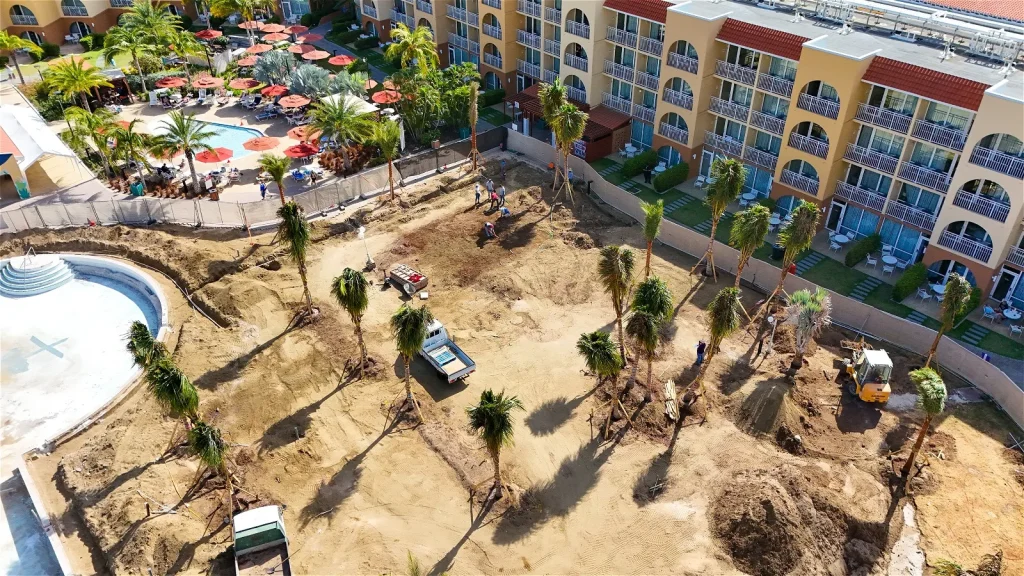

UPDATE #5 ON PHASE 2B RENOVATION
- We installed new palm trees to enhance the surroundings.
- Currently, we are working on the construction of the new towel hut.
- We continue with the installation of pipes for utilities, data, and other essential infrastructure.
- We removed all the old pool filtration equipment and are about to pour a new floor in the pool pump house to eventually install the new equipment.
ACTUALIZACIÓN #5 SOBRE LA RENOVACIÓN DE LA FASE 2B
Renovación de la Piscina y la Cubierta de la Piscina
25 de marzo de 2025
Como sabrán, la renovación de nuestra piscina principal y la cubierta de la piscina está en progreso y se espera que se complete para diciembre de 2025. Durante este tiempo, tanto la piscina para adultos como la nueva piscina para niños permanecerán completamente accesibles para su disfrute. Nos complace mantenerlos informados sobre nuestro proyecto de renovación en curso. Recientemente
• Hemos eliminado todo el equipo de filtración de la piscina antigua y estamos a punto de verter un nuevo piso en la casa de bombas de la piscina para eventualmente instalar el nuevo equipo.
Los invitamos a seguir el progreso en línea a través de nuestras cámaras web en vivo.
Tengan en cuenta que las actividades de construcción implicarán períodos de perforación, ruido de maquinaria y polvo en las áreas circundantes. Si bien entendemos que esto puede causar algunas molestias, estas mejoras reflejan nuestro compromiso continuo de mejorar el resort para su disfrute continuo.
Agradecemos sinceramente su paciencia y comprensión durante este proceso y pedimos disculpas por cualquier interrupción. Gracias por su apoyo mientras trabajamos para crear una experiencia aún mejor para todos.
Equipo de La Cabana

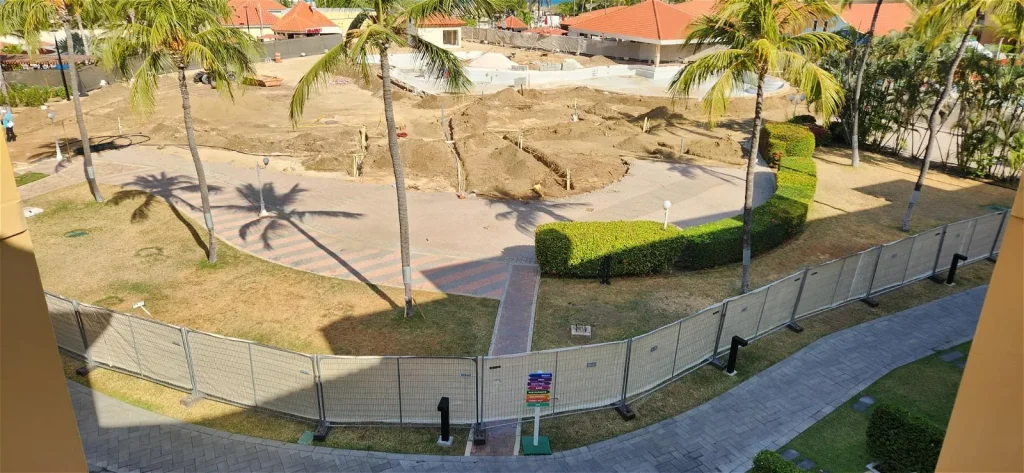

UPDATE# 4 ON PHASE 2B RENOVATION
As you may know, the renovation of our main pool and pool deck is currently in progress and is expected to be completed by December 2025.
- Excavation of trenches around the pool deck for water, electricity, data, and other utility conduits is still underway.
- The foundation for the two new jacuzzies is currently being laid.
- Trees and bushes have been removed to prepare the area for the construction of the new towel hut.
- Prep work being done to plant new trees and landscape layout on east side bordering walkway.
- Support for pipes penetration to pool pumphouse underway.
- La excavación de zanjas alrededor de la terraza de la piscina para agua, electricidad, datos y otros conductos de servicios públicos aún está en curso.
- Se está colocando la base para los dos nuevos jacuzzis.
- Se han eliminado árboles y arbustos para preparar el área para la construcción de la nueva cabaña de toallas.
- Se están realizando trabajos de preparación para plantar nuevos árboles y el diseño del paisaje en el lado este que bordea el paseo.
- Se está llevando a cabo el soporte para la penetración de tuberías hacia la casa de bombas de la piscina.

UPDATE# 3 ON PHASE 2B RENOVATION
Pool and Pool Deck Renovation
February 25, 2025
As you may be aware, the renovation of our main pool and pool deck is currently underway and is expected to be completed by December 2025.
During this period, the adult pool and the new kids’ pool will remain fully accessible for your enjoyment.
With 30+ days into the renovation, we would like to provide you with an update on the progress:

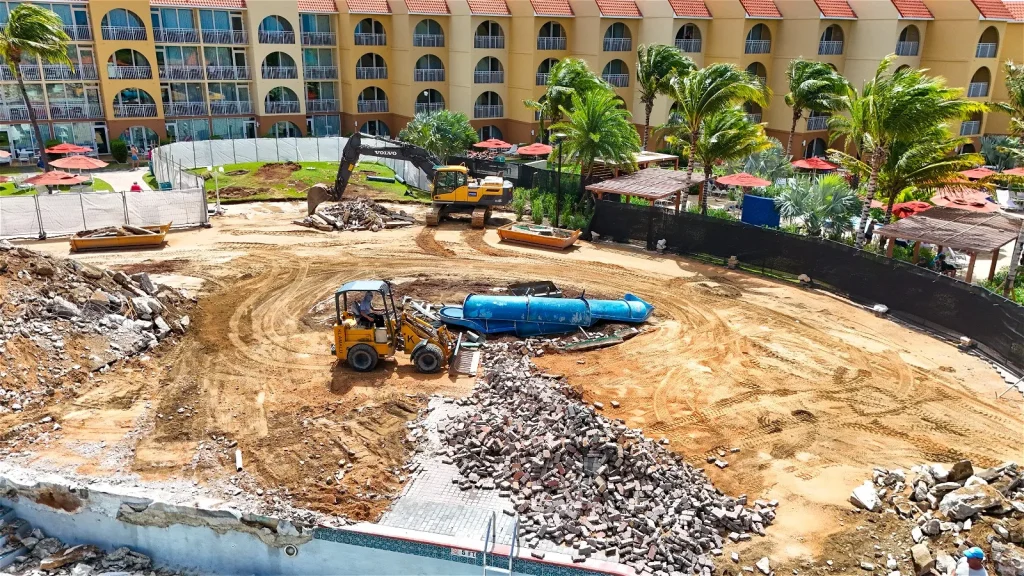

- We completed the major demolition around the pool deck.
- Trenches have been excavated around the pool deck to accommodate piping/conduits for water, electricity, data, and other utilities.
- The West Side project, which involves connecting a power feeder to the pump room and extending a sewage line to the front of the property, began on February 19th and is expected to continue for several weeks.
- The East Side project, scheduled to begin on March 3rd, will include the removal of six palm trees, installation of drainage and a waterline, and the building of our new towel hut. As a result, the fence will be temporarily extended to the walkway, and tables, umbrellas and chairs will be relocated to the grassy area east of the kids’ pool.
Please note that construction activities will involve periods of drilling, machinery noise, and dust in the surrounding areas.
While we understand that this may cause some inconvenience, these enhancements are part of our ongoing commitment to improving the resort for your continued enjoyment.
We sincerely appreciate your patience and understanding during this process and apologize for any disruptions.
Thank you for your support as we work to create an even better experience for all.
UPDATE #2 FEBRUARY 11, 2025
ONGOING POOL & POOL DECK RENOVATION
As we have been informing you, the renovation of our pool and pool deck is currently underway and is expected to continue through the second week of December 2025.
In the meantime, the new adult pool and kids’ pool remain accessible, and we encourage guests to take advantage of the beach, as seating on the pool deck is currently limited.

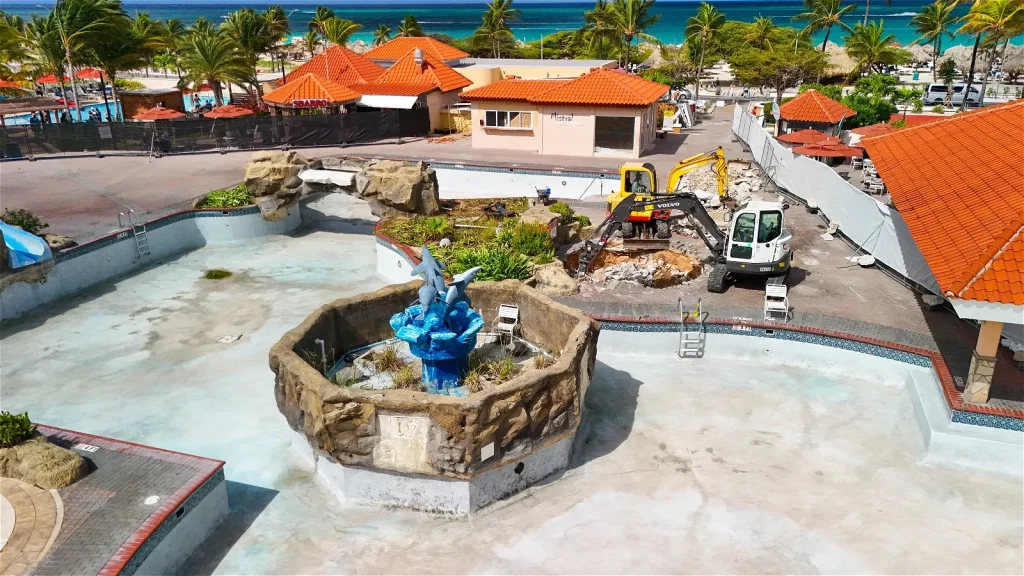

To give you an update on what has happened so far, the pavers around the pool deck have been removed, and demolition work has been completed on the old kids’ pool, jacuzzis, dolphin tower, waterslide, bridge, and towel hut. Contractors are now clearing out the remaining construction debris. Soon, they will begin excavating trenches to access and replace the underground piping as part of the renovation.
Please be aware that during this project, there will be periods of drilling, machinery noise, and dust in the surrounding areas. While we understand this may cause some inconvenience, these upgrades reflect our commitment to enhancing the resort experience for your enjoyment.
We sincerely appreciate your patience and understanding as we work to create a better and more enjoyable environment for all.
RENOVACIÓN EN CURSO DE LA PISCINA Y LA TERRAZA DE LA PISCINA
Como les hemos estado informando, la renovación de nuestra piscina y la terraza de la piscina está en marcha y se espera que continúe hasta la segunda semana de diciembre de 2025.
Mientras tanto, la nueva piscina para adultos y la piscina para niños siguen siendo accesibles, y alentamos a nuestros huéspedes a disfrutar de la playa, ya que el espacio para sentarse en el deck de la piscina es limitado.
Para mantenerlos actualizados sobre los avances, los adoquines alrededor del deck de la piscina han sido removidos, y se ha completado la demolición de la antigua piscina para niños, los jacuzzis, la torre del delfín, el tobogán de agua, el puente y la antigua caseta de toallas. Actualmente, los contratistas están retirando los escombros restantes de la obra. Pronto comenzarán a excavar zanjas para ubicar y reemplazar las tuberías subterráneas como parte del plan de renovación.
Tengan en cuenta que, durante este proyecto, habrá períodos de perforaciones, ruido de maquinaria y polvo en las áreas cercanas. Si bien entendemos que esto puede causar algunas molestias, estas mejoras reflejan nuestro compromiso de brindar una experiencia aún mejor en el resort para su disfrute.
Agradecemos sinceramente su paciencia y comprensión mientras trabajamos para crear un ambiente más agradable y placentero para todos.

UPDATE #1
JANUARY 28, 2025
As you are aware, the renovation of our pool and pool deck is now underway and is expected to last through the second week of December 2025.
The construction area has been securely fenced off, and the pool has been carefully drained in compliance with specific guidelines to prevent overloading the drainage system.
Demolition of the old kids’ pool, the jacuzzi by the Pata Pata Bar, the bridge, and the towel hut has started.
Colorful signage has been installed to clearly mark designated walkways, temporary showers have been set up to replace the ones near the beach ramp, which is currently inaccessible, and a temporary staircase has been added exclusively for access to Citro Spa.
Please note that during this renovation project, there will be periods of drilling, machinery noise, and dust in the surrounding areas. While we understand that this may cause some inconvenience, these upgrades are part of our commitment to enhancing the resort experience for your enjoyment.
We sincerely apologize for any disruption and thank you for your patience and understanding as we work to create a better and more enjoyable environment for all.
ACTUALIZACIÓN SOBRE LA RENOVACIÓN DE LA FASE 2B
28 DE ENERO DE 2025
Como sabrán, la renovación de nuestra piscina y la terraza de la piscina está en marcha y se espera que finalice en la segunda semana de diciembre de 2025.
El área de construcción ha sido cercada de forma segura, y la piscina se ha vaciado cuidadosamente cumpliendo con las directrices específicas para evitar sobrecargar el sistema de drenaje.
La demolición de la antigua piscina infantil, el jacuzzi junto al Pata Pata Bar, el puente y la caseta de toallas ha comenzado.
Se han colocado letreros coloridos para marcar claramente las áreas de pasose han instalado duchas temporales para reemplazar las cercanas a la rampa de la playa, que actualmente no está accesible, y se ha añadido una escalera temporal exclusivamente para el acceso a Citro Spa.
Tengan en cuenta que durante este proyecto de renovación habrá períodos con ruido de perforaciones, maquinaria y polvo en las áreas circundantes. Aunque entendemos que esto puede causar algunas molestias, estas mejoras son parte de nuestro compromiso de optimizar la experiencia en el resort para su disfrute.
Lamentamos sinceramente cualquier inconveniente y agradecemos su paciencia y comprensión mientras trabajamos para crear un ambiente mejor y más agradable para todos.
La Cabana BRC Team

Here's a special message from our General Manager on Phase 2B!
Get an inside look at all the incredible changes coming your way, designed to make your stay even more memorable.
